Share 27 May 2024 on Facebook
Share 27 May 2024 on Linkedin
Email 27 May 2024 link
The toilet block is now complete and open for use.
Share Project Update - 28 February 2024 on Facebook
Share Project Update - 28 February 2024 on Linkedin
Email Project Update - 28 February 2024 link
Construction of the new toilet block at the Eastwood Playspace will commence in the coming days.
The playground will remain open while these works are being undertaken; although the playground will still be open, there will be construction fencing and increased vehicle movements in the area and we ask for children to be monitored and visitors to remain alert and avoid distractions.
Share Project Update - 21 December 2023 on Facebook
Share Project Update - 21 December 2023 on Linkedin
Email Project Update - 21 December 2023 link
The construction of the barbeque shelter has been completed, providing shade and shelter.
Furniture and barbeque facilities will be installed after the Christmas break.
Share Project Update - 13 December 2023 on Facebook
Share Project Update - 13 December 2023 on Linkedin
Email Project Update - 13 December 2023 link
|
|
|
|
|
The installation of the playground is now complete.
Construction of the BBQ shelter has commenced.
|
Share Project Update - 23 October 2023 on Facebook
Share Project Update - 23 October 2023 on Linkedin
Email Project Update - 23 October 2023 link

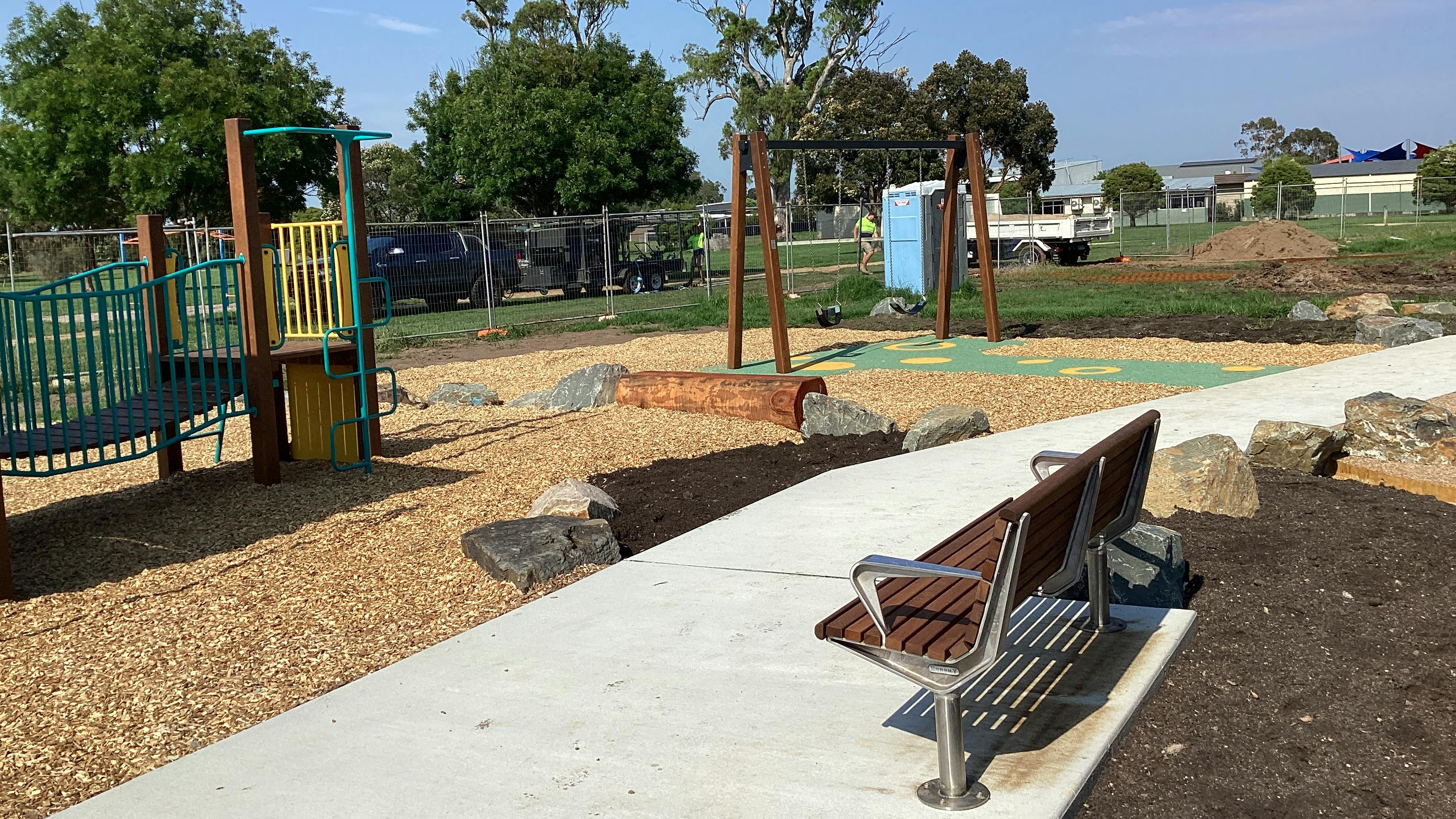

The playground is really taking shape, with our in-house crew preparing the concrete around the play equipment ready for the rubber soft fall to be installed.
Stepping logs and balance logs are scheduled to be delivered later this week. Once the logs are installed, the soft fall materials will be laid, and garden areas completed. The basket swing and child swing seats will be installed following the placement of the soft fall materials.
Share Project Update - 3 October 2023 on Facebook
Share Project Update - 3 October 2023 on Linkedin
Email Project Update - 3 October 2023 link
The construction of a toilet block will be completed by the end of the financial year.
Contributing to creating a more enjoyable, safe, and inclusive recreational experience, a toilet block has been designed for construction at the new play space in Eastwood.
The new toilet block will include two disabled and family friendly units, providing a convenient and accessible facility for children and adults who may need to use the restroom while enjoying the playground. The inclusion of a toilet block will also allow families to spend longer periods at the playground, promoting physical activity and socialization.
Toilet Block Concept Design
Share Project Update - 26 September 2023 on Facebook
Share Project Update - 26 September 2023 on Linkedin
Email Project Update - 26 September 2023 link
The Adventure+ playground equipment has been installed.
The playground is progressing well. Stepping logs and balance logs are expected to be delivered and put in place in the coming weeks. Once the logs are installed, the soft fall materials will be laid, and garden areas completed. The basket swing and child swing seats will be installed following the placement of the soft fall materials.
The footpath connecting the car park to the play area has been completed and we will cleanup and backfill around the path over the next couple of days. Once a building permit is obtained, we will commence the construction of the BBQ shelter and furniture.
Share Project Update - 17 August 2023 on Facebook
Share Project Update - 17 August 2023 on Linkedin
Email Project Update - 17 August 2023 link
Have you seen us on site at the new Eastwood Play Space this week?
The concrete footpath has been poured around the area marked out for the play equipment and the project is progressing well. The concreting was done by Fox Martin Concrete and Construction on behalf of Friths Plumbing and Civil Construction, who were awarded the contract for the civil works and concrete package.
The connection to the carpark will be completed the first week of the September school holidays.
Our Council crew will work together with Adventure+ to install the play equipment in mid-late September. Landscaping will commence once the play equipment is in.
Share Project Update - 10 July 2023 on Facebook
Share Project Update - 10 July 2023 on Linkedin
Email Project Update - 10 July 2023 link
Civil works has been awarded with the contractor mobilising on site on 17 July 2023.
Civil works are estimated to be completed by the end of November 2023, at which time the playground and landscaping will be installed.
Share Project Update - 18 May 2023 on Facebook
Share Project Update - 18 May 2023 on Linkedin
Email Project Update - 18 May 2023 link
Council has worked through the tender evaluation for the civil works and will be awarding the contract shortly. A construction schedule will be made available once awarded.
We have commenced purchasing play items, which will be installed after the civil works has been completed. Landscaping will commence following the installation of the play items.
