Share Mallacoota - Mudbrick Pavilion Upgrade on FacebookShare Mallacoota - Mudbrick Pavilion Upgrade on TwitterShare Mallacoota - Mudbrick Pavilion Upgrade on LinkedinEmail Mallacoota - Mudbrick Pavilion Upgrade link

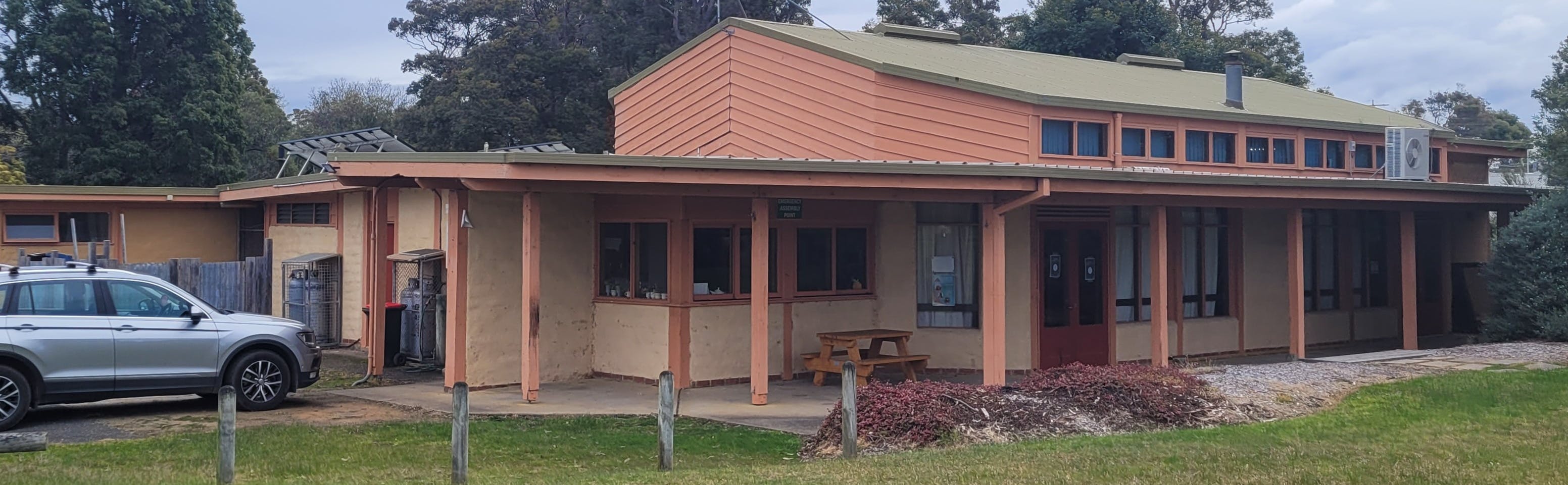

Mallacoota Mudbrick Pavilion is a valuable, volunteer built, heritage building that was originally constructed as a soccer pavilion. It has been used for many years as the local community hall and hub for performing arts. The building is used by many community organisations for meetings and events.
The project will see the upgrade the entire facility to meet growing demand through the refurbishment of the existing structure along with some small extensions.
The proposed outcomes of the Mallacoota Mudbrick Pavilion are:
Upgrade the kitchen and bring this facility up to commercial grade with hygiene stations for hand washing and cleaning
An all-abilities toilet to be installed within the pavilion.
External toilets to be refurbished
Upgrade/extension of storage facilities
Rebuild of stage to provide additional depth and upgrade of stage access to improve safety and amenity.
Construction of separate studio/workshop, including dedicated wash-up facilities.
Budget/Funding
This project is funded through the Australian Government Black Summer Bushfire Recovery Grants Program.
To receive important project updates, please subscribe.
Mallacoota Mudbrick Pavilion is a valuable, volunteer built, heritage building that was originally constructed as a soccer pavilion. It has been used for many years as the local community hall and hub for performing arts. The building is used by many community organisations for meetings and events.
The project will see the upgrade the entire facility to meet growing demand through the refurbishment of the existing structure along with some small extensions.
The proposed outcomes of the Mallacoota Mudbrick Pavilion are:
Upgrade the kitchen and bring this facility up to commercial grade with hygiene stations for hand washing and cleaning
An all-abilities toilet to be installed within the pavilion.
External toilets to be refurbished
Upgrade/extension of storage facilities
Rebuild of stage to provide additional depth and upgrade of stage access to improve safety and amenity.
Construction of separate studio/workshop, including dedicated wash-up facilities.
Budget/Funding
This project is funded through the Australian Government Black Summer Bushfire Recovery Grants Program.
To receive important project updates, please subscribe.
Share 20 December 2024 on FacebookShare 20 December 2024 on TwitterShare 20 December 2024 on LinkedinEmail 20 December 2024 link
With significant progress made over recent months, the Mudbrick Pavilion building works are nearing completion.
Vinyl Plank Flooring: Installation is now complete.
Stage Refurbishment: The stage has been successfully refurbished, adding to the versatility of the venue.
Cleaners Mop Basin: To be installed early 2025
Studio/workshop: This will be prefabricated off-site and delivered in the New Year.
These updates mark a significant step forward for the Mudbrick Pavilion, ensuring the pavilion is available during the holiday break to accommodate existing bookings whilst maintaining its community-focused goals.
The revised project completion date is set for the end of March 2025.
Share 16 September 2024 on FacebookShare 16 September 2024 on TwitterShare 16 September 2024 on LinkedinEmail 16 September 2024 link
Further updates will be provided on YourSay following the Council Election on 26 October 2024, and the questions/feedback tab will be reinstated.
From 12.00 noon Tuesday 17 September until 6.00 pm on Saturday 26 October (Election Day) we will be in the Local Government Election Period (also known as Caretaker Period).
During this time, we will limit our printed communications, website content, social media activity, and community consultations. The ability for people to comment on our social media content will also be disabled during the Election Period.
Each of these steps is to ensure our content does not affect voting in the election and is consistent with steps taken by other Victorian Councils and the Local Government Act 2020.
These changes are only temporary; we'll be back to normal communication activity after the election.
Share 7 August 2024 on FacebookShare 7 August 2024 on TwitterShare 7 August 2024 on LinkedinEmail 7 August 2024 link
We are excited to share that significant progress has been made on the Pavilion renovation project - here's an update!
Internal Plastering: The plastering work inside the Mudbrick Pavilion has been successfully completed. The new walls are now ready for the next stages of finishing.
Lighting: The installation of the new lighting system has been finalised, enhancing the facility's ambiance and functionality.
Sound Booth Wall: The wall for the sound booth in the theatre is complete. We consulted with a sound engineer from the Forge in Bairnsdale to ensure the design meets our acoustic needs and provides the best possible sound experience.
What's next? All remaining components for the project are now on hand, and we are in the process of scheduling their installation over the coming weeks.
We are working diligently to complete the renovations and are enthusiastic about the improvements that will benefit everyone in the community. Our goal is to hand over the upgraded Mudbrick Pavilion to the Mallacoota Recreation Reserve and Halls Committee of Management by the end of August 2024.
Thank you for your continued support and patience. We look forward to unveiling the enhanced Mudbrick Pavilion and celebrating its new features with you soon!
Share Project Update - 13 February 2024 on FacebookShare Project Update - 13 February 2024 on TwitterShare Project Update - 13 February 2024 on LinkedinEmail Project Update - 13 February 2024 link
The Stage-1 upgrades to the kitchen are now complete.
Works to upgrade the toilets and the workshop store have commenced.
Share Project Update - 18 August 2023 on FacebookShare Project Update - 18 August 2023 on TwitterShare Project Update - 18 August 2023 on LinkedinEmail Project Update - 18 August 2023 link
Upgrades to the Mallacoota Mudbrick Pavilion have commenced.
The kitchen is undergoing a transformation, with new equipment and cabinetry being installed and designed in a way to retain the original character of the building. Much of the building upgrade works are being completed by Council teams to meet budget requirements and project deadlines.
Any required closures will be limited to minimise interruption to the operation schedule of the pavilion and will be advised in advance.
Share Project Update 6/04/2023 on FacebookShare Project Update 6/04/2023 on TwitterShare Project Update 6/04/2023 on LinkedinEmail Project Update 6/04/2023 link
Design drawings were received last week.
We are currently waiting for the engineering design for the removal of structural elements.
Due to delays with design documents the project is likely to begin in the 2023/24 financial year.
Share Project Update 28/02/2023 on FacebookShare Project Update 28/02/2023 on TwitterShare Project Update 28/02/2023 on LinkedinEmail Project Update 28/02/2023 link
The detailed design of the kitchen is complete.
Construction is planned to commence in mid 2023 under the supervision of the EGSC building crew.
