Buchan is celebrating a significant upgrade to its main road and walking path connections, following the completion of the Buchan Main Street and Linkages Project.
Undertaken in two parts, this significant project commenced in November 2022 with the creation of a 2.5m-wide, 1300m-long shared pathway connecting Buchan to the limestone Buchan Caves and surrounding park.
In addition to the pathway, significant upgrades to the town’s streetscape include new parking areas near key locations such as the Buchan Playground, CFA facility, and Mechanics Hall.

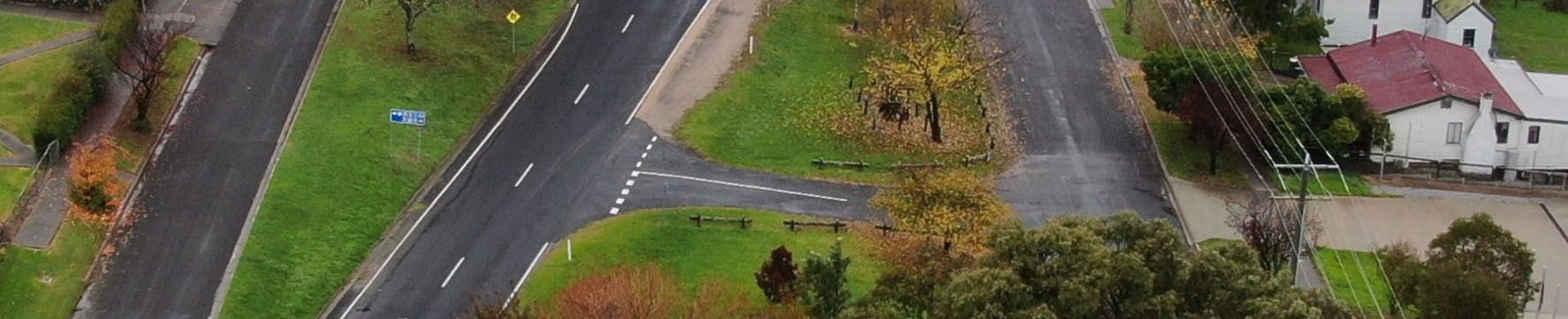

Roads have been re-sealed with new line markings to increase safety for both vehicles and pedestrians. The installation of new street furniture, including tables, has enhanced the town’s aesthetic appeal, making it more inviting for locals and visitors to the area.
Our contractor, Fulton Hogan Industries Pty Ltd, faced design related challenges throughout the entire project and have done a great job delivering this project for the Buchan Community and visitors to the area with.
Charging ahead in Buchan
Buchan is the latest town charging into the future with a new electric vehicle charging station installed. This 24kW DC ABB charger is strategically located as part of the recent streetscape upgrade, complete with a dedicated car park for electric vehicles. The charger can add an average of 120 kilometers of range per hour, making it convenient for both residents and visitors.
The new charging station is expected to have multiple benefits. Not only will it support the growing number of electric vehicle drivers, but it will also encourage more visitors to explore Buchan, boosting the local economy. With easy access to charging, electric vehicle owners can enjoy the scenic attractions of Buchan without range anxiety.
Once AusNet provides the electricity supply, the charging station will be commissioned and the ChargeFox software will be installed in the coming months. It will be powered by 100% renewable electricity, making it an environmentally sustainable transport option.
For more information about the electric vehicle charging stations in East Gippsland, visit the Your Say page: electric-vehicle-charging-stations.
For more information about the EV charger, contact Rebecca Lamble, Sustainability Officer on 5153 9500 or via email to feedback@egipps.vic.gov.au
Share 1 August 2024 on Facebook
Share 1 August 2024 on Linkedin
Email 1 August 2024 link
Civil works along the north side service road are almost complete, and things are really taking shape.
We’ve widened the road shoulder for better parking and moved the bus stop to the south side service road.
The upmost care was taken while we repositioned the rock cairn monument to accommodate the new kerb and channel and carparking.
In the Community Hall carpark, we're adding new parking spaces where possible, including a brand-new disabled parking bay.
Signage and street furniture installation is continuing, and entire site will be given a general tidy up. The north service road will soon get a fresh asphalt overlay with line-marking. Fulton Hogan, our contractor, is keen to wrap up everything in the next 3-4 weeks.
Mid to late August 2024 will see the installation of the new EV Charger. Our in-house parks and gardens team will be busy with street tree replacement and plantings throughout the new garden beds, once the weather begins to warm up.
We welcome your continued interest in this project. Please choose to follow this project on YourSay to receive important information regarding this project directly to your inbox.
Share 26 June 2024 on Facebook
Share 26 June 2024 on Linkedin
Email 26 June 2024 link
Due to recent weather conditions and some adjustments to the design based on valuable feedback from our community, we have encountered a slight delay in completion.
Following discussions with community members, we have made minor design changes to ensure the final results align with everyone's expectations and needs.
Notably, we will maintain angle parking in front of the pub and down to the general store as requested by local business owners.
Our contractor, Fulton Hogan Industries P/L, anticipate completing the project towards the end of July 2024.
We understand that delays can be frustrating, and we sincerely appreciate your patience as we continue to collaborate closely with the community to achieve the best possible outcomes for all involved.
Thank you for your ongoing support and understanding.
Share 8 May 2024 on Facebook
Share 8 May 2024 on Linkedin
Email 8 May 2024 link
Construction is progressing on the south side of Main Street.
The contractor is currently establishing footpath connections between the shops and the toilet block, as well as continuing with road pavement construction. Works on the south side are expected to be completed in the coming weeks, with line marking, street furniture and signage installed.
Works will be undertaken on the north side of Main Street, including drainage upgrades, kerb replacement and an asphalt overlay to Shire managed service roads.
A landscaping and tree replacement program will follow shortly after the civil works are completed and will be undertaken by Council’s in-house team.
Council anticipates construction to be finalised by the end of June 2024 and will keep the community updated throughout the process.
Additional photos are available in the Photos tab: Photos - Buchan Main Street and Linkages Project
We welcome your continued interest in this project. Please feel free to share this update with your local network and choose to follow this project on YourSay to receive important information regarding this project directly to your inbox.
Share 4 April 2024 on Facebook
Share 4 April 2024 on Linkedin
Email 4 April 2024 link
Works are progressing well.
Construction of the court and footpath connections along the south side of Main Street are well underway.
Works surrounding the toilet block are underway, which involve additional drainage enhancements, footpaths, and landscaping. The relocation of the BBQ and the replacement of current street furniture are expected to occur in the upcoming weeks.
The installation of the electric vehicle charger proposed for the site is also anticipated to commence shortly and should be operational by June 2024
Share Project Update - 21 December 2023 on Facebook
Share Project Update - 21 December 2023 on Linkedin
Email Project Update - 21 December 2023 link
Our Contractor Fulton Hogan Industries Pty Ltd has made some real progress onsite, with a large section of the work nearly complete on the south side between the John Flynn Reserve and the Willows Café.
Drainage improvements are ongoing throughout the site, which will allow for related landscaping and tree planting to commence in the new year.
Works are scheduled to be completed by early May 2024.
Share Project Update - 8 December 2023 on Facebook
Share Project Update - 8 December 2023 on Linkedin
Email Project Update - 8 December 2023 link
Buchan Streetscape Redevelopment
Fulton Hogan Industries Pty Ltd have commenced works onsite along the south side Service Road, from the John Flynn Reserve through to Willows Café.
Following a short Christmas holiday shut down period, works will continue through the New Year along this section of the service road to the public toilets (from 29 January 2024).
This exciting Project for the Buchan Community will see not only the existing drainage infrastructure upgraded or replaced, but the overall amenity of the Buchan township improved for residents, businesses, and visitors to the area.
Buchan Linkages Project
The newly constructed Buchan Linkages Project has experienced its first flood event and has held up well. The river flat area, between the Main Road Bridge and the Caves House on Caves Road is currently having silt and debris removed by Parks Victoria staff to allow for the walking path to be re-opened. The lighting bollards certainly provided a spectacle for those who witnessed the weekend flooding event.
Further photos have been added to the photos section.
Share Project Update - 10 October 2023 on Facebook
Share Project Update - 10 October 2023 on Linkedin
Email Project Update - 10 October 2023 link
The contract for the Buchan Main Street and Linkages project civil works was awarded at the 5 September Council meeting to Fulton Hogan Industries Pty Ltd. The contractors anticipate mobilisation to site in November 2023 for the commencement of construction.
We are mindful of community activity and visitor movements leading into the peak tourist season and will make every effort to minimise the potential impact of the works within the township.
Dates will be advised when available.
Share Project Update - 10 August 2023 on Facebook
Share Project Update - 10 August 2023 on Linkedin
Email Project Update - 10 August 2023 link
The Buchan Streetscape project is progressing towards construction. An updated layout plan is available to be viewed in the documents sections (or click on the green link above).
Minor adjustments to the final design have been necessary to align with available budget, these changes will not impact the general delivery of the streetscape project.
The key outcomes that will be delivered are:
- Car parking will be increased within the town.
- Both service roads will remain two-way.
- The area near the existing playground and toilet block will be formalised and activated as shown in the previous design.
- Additional carparking will be implemented near the playground and the adjacent the CFA Shed.
- Additional carparking will be implemented adjacent the Hall.
- Roads will be re-sealed and line marked. This will improve vehicle and pedestrian safety
- Long Vehicle carparking will be created and sign posted.
- Pram crossings will be realigned to provide safer crossing points.
- Street furniture will be upgraded, and additional tables installed, where appropriate.
- Additional tree plantings and gardens will be installed.
Commencement of construction is to be confirmed once a contractor has been engaged to undertake the works.
Council will be in contact with property owners that may be impacted by the works.
Share Project Update 23 May 2023 on Facebook
Share Project Update 23 May 2023 on Linkedin
Email Project Update 23 May 2023 link
There has been a slight delay in the proposed asphalt works for this week due to weather.
We expect the works to be completed early next week (weather dependent).
