Paynesville - Slip Road Maritime Precinct
Updates are provided in the tab below
The upgrade of Paynesville's Slip Road Maritime Precinct originated from Council’s adoption of the Paynesville Maritime Precinct Masterplan and has been undertaken to bring significant benefits to the local economy and enhance Paynesville as a year-round destination for visitors, residents, and businesses alike.
Construction commenced in January 2022 with Carter Marine Group starting onsite piling works and offsite fabrication of precast elements for the services jetty. Works were later delayed due to a review of the project’s detailed design following the discovery of unforeseen lakebed conditions.
Carter Marine Group temporarily demobilised from the project site to work on another project in the Lakes Entrance area, and Council engaged an independent contractor to carry out further offshore geotechnical works which were used to update and improve the detailed design.
The new design will ensure the upgrade of the Slip Road Maritime Precinct is structurally secure and better caters to surrounding marine businesses and overflow tourism activities. These improvements are designed to have a lifespan of around 50 years.
Carter Marine was awarded a varied contract for construction of the seawall, jetties and boardwalk. A tender for construction of the carpark and landscaping will be advertised later this year following the finalisation of the marine based work by Carter Marine.
Once remobilised, Carter Marine Group construct the seawalls, services, jetty, and ramp. We appreciate Carter Marine’s cooperation and understanding throughout this process.
The planning and design of the carpark construction is progressing. A Project Reference Group (PRG) will guide this stage of the project and inform the development of the detailed design.
Both the Victorian and Federal governments have recognised the significance of this project by providing significant funding, and we acknowledge their understanding and support for this re-design work.
Objective and Scope
Revitalisation of the Slip Road Maritime Precinct will include -
- construction of new seawall and jetties
- new boat ramp
- Carparking upgrade
- boardwalks
- pathways
- landscaping and art installation
- amenity block upgrade (complete)
Funding
This project is supported by the Australian Government, Victorian Government, and East Gippsland Shire Council.
Updates are provided in the tab below
The upgrade of Paynesville's Slip Road Maritime Precinct originated from Council’s adoption of the Paynesville Maritime Precinct Masterplan and has been undertaken to bring significant benefits to the local economy and enhance Paynesville as a year-round destination for visitors, residents, and businesses alike.
Construction commenced in January 2022 with Carter Marine Group starting onsite piling works and offsite fabrication of precast elements for the services jetty. Works were later delayed due to a review of the project’s detailed design following the discovery of unforeseen lakebed conditions.
Carter Marine Group temporarily demobilised from the project site to work on another project in the Lakes Entrance area, and Council engaged an independent contractor to carry out further offshore geotechnical works which were used to update and improve the detailed design.
The new design will ensure the upgrade of the Slip Road Maritime Precinct is structurally secure and better caters to surrounding marine businesses and overflow tourism activities. These improvements are designed to have a lifespan of around 50 years.
Carter Marine was awarded a varied contract for construction of the seawall, jetties and boardwalk. A tender for construction of the carpark and landscaping will be advertised later this year following the finalisation of the marine based work by Carter Marine.
Once remobilised, Carter Marine Group construct the seawalls, services, jetty, and ramp. We appreciate Carter Marine’s cooperation and understanding throughout this process.
The planning and design of the carpark construction is progressing. A Project Reference Group (PRG) will guide this stage of the project and inform the development of the detailed design.
Both the Victorian and Federal governments have recognised the significance of this project by providing significant funding, and we acknowledge their understanding and support for this re-design work.
Objective and Scope
Revitalisation of the Slip Road Maritime Precinct will include -
- construction of new seawall and jetties
- new boat ramp
- Carparking upgrade
- boardwalks
- pathways
- landscaping and art installation
- amenity block upgrade (complete)
Funding
This project is supported by the Australian Government, Victorian Government, and East Gippsland Shire Council.
-
📅 January 2026
Share 📅 January 2026 on Facebook Share 📅 January 2026 on Twitter Share 📅 January 2026 on Linkedin Email 📅 January 2026 linkSlip Road Marina Precinct Upgrade is progressing and due for completion June 2026.
What’s happening now:
- Marina Jetty 2 is nearing completion
- Jetty number 3 is in the prefabrication stage.
- Boat ramp prefabrication complete and ready for installation.

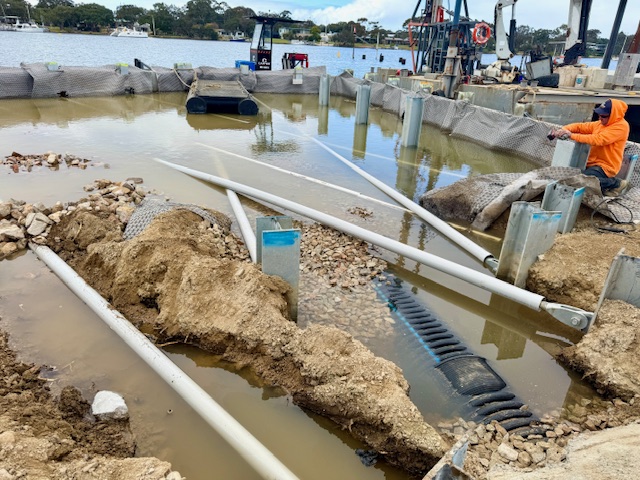

- Service Jetty prefabrication nearing completion and expected to be installed in a couple of months.
- Fire and potable water design complete and ready for construction in the next 2 months.
- Hydro seeding of southern section complete, with regular watering happening to ensure maximum seed strike.
What’s happening next:
- Underground services installation is expected to be completed in January.
- Boat ramp and jetty installations.
- Kerbing, landscaping, and carpark asphalting will be completed once the above works have been completed.
Slip Road Marina Precinct Upgrade is progressing and due for completion June 2026.
What’s happening now:
- Marina Jetty 2 is nearing completion
- Jetty number 3 is in the prefabrication stage.
- Boat ramp prefabrication complete and ready for installation.
- Service Jetty prefabrication nearing completion and expected to be installed in a couple of months.
- Fire and potable water design complete and ready for construction in the next 2 months.
- Hydro seeding of southern section complete, with regular watering happening to ensure maximum seed strike.
What’s happening next:
- Underground services installation is expected to be completed in January.
- Boat ramp and jetty installations.
- Kerbing, landscaping, and carpark asphalting will be completed once the above works have been completed.
-
📅 October 2025
Share 📅 October 2025 on Facebook Share 📅 October 2025 on Twitter Share 📅 October 2025 on Linkedin Email 📅 October 2025 linkThe first sections of Jetty 3 have now been successfully installed – marking another milestone in the transformation of the Paynesville Maritime Precinct
This new jetty will span approximately 80 metres in length and 2.4 metres in width, creating a total of around 40 new berths in the marina. Once complete, it will feature floating finger pontoon jetties on either side and a gangway to provide safe and convenient access from land.
These upgrades are designed to enhance access, usability, and enjoyment for both locals and visitors, supporting recreational boating, tourism, and local business opportunities.
What’s Happening Now:

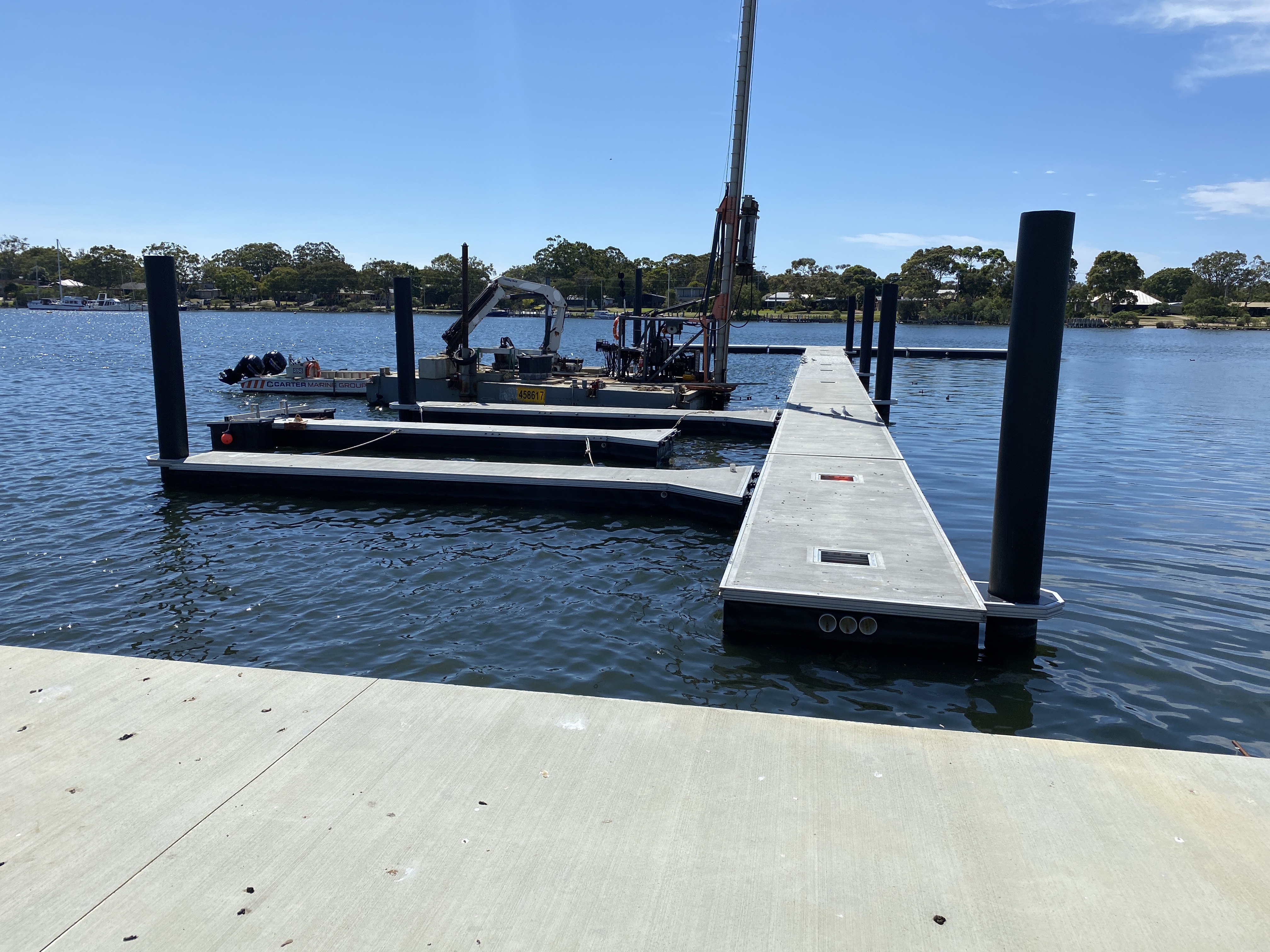

- Floating Pontoons: Fabrication and installation continue, with the first section now in place.
- Landscaping: Kerbing, topsoil, and seeding are underway behind the northern seawall to green and beautify the area.

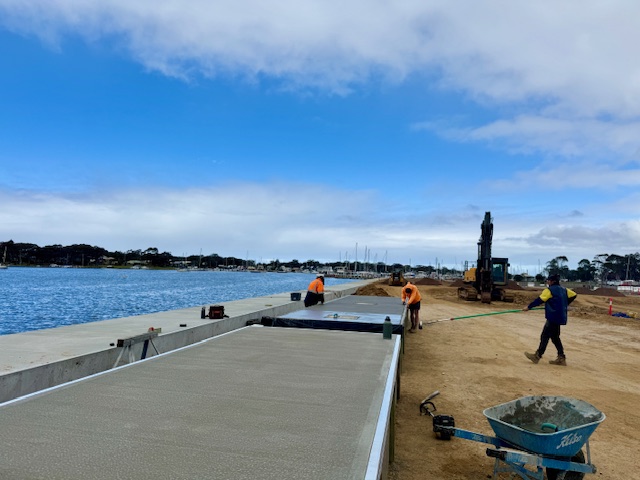

- Boat Ramp Upgrade: A new, longer and deeper commercial boat ramp is being prefabricated and installed to improve functionality.
- Utilities Commissioning: Power, water, and fire services are being activated across the precinct.
- Car Park Improvements: Sealing, asphalting, and line marking are progressing to improve traffic flow and accessibility.
These works reflect our commitment to delivering a modern, functional, and inclusive maritime precinct that meets the needs of the Paynesville community and its visitors.
Thank you for your continued interest and support – we look forward to sharing more updates as the project progresses.

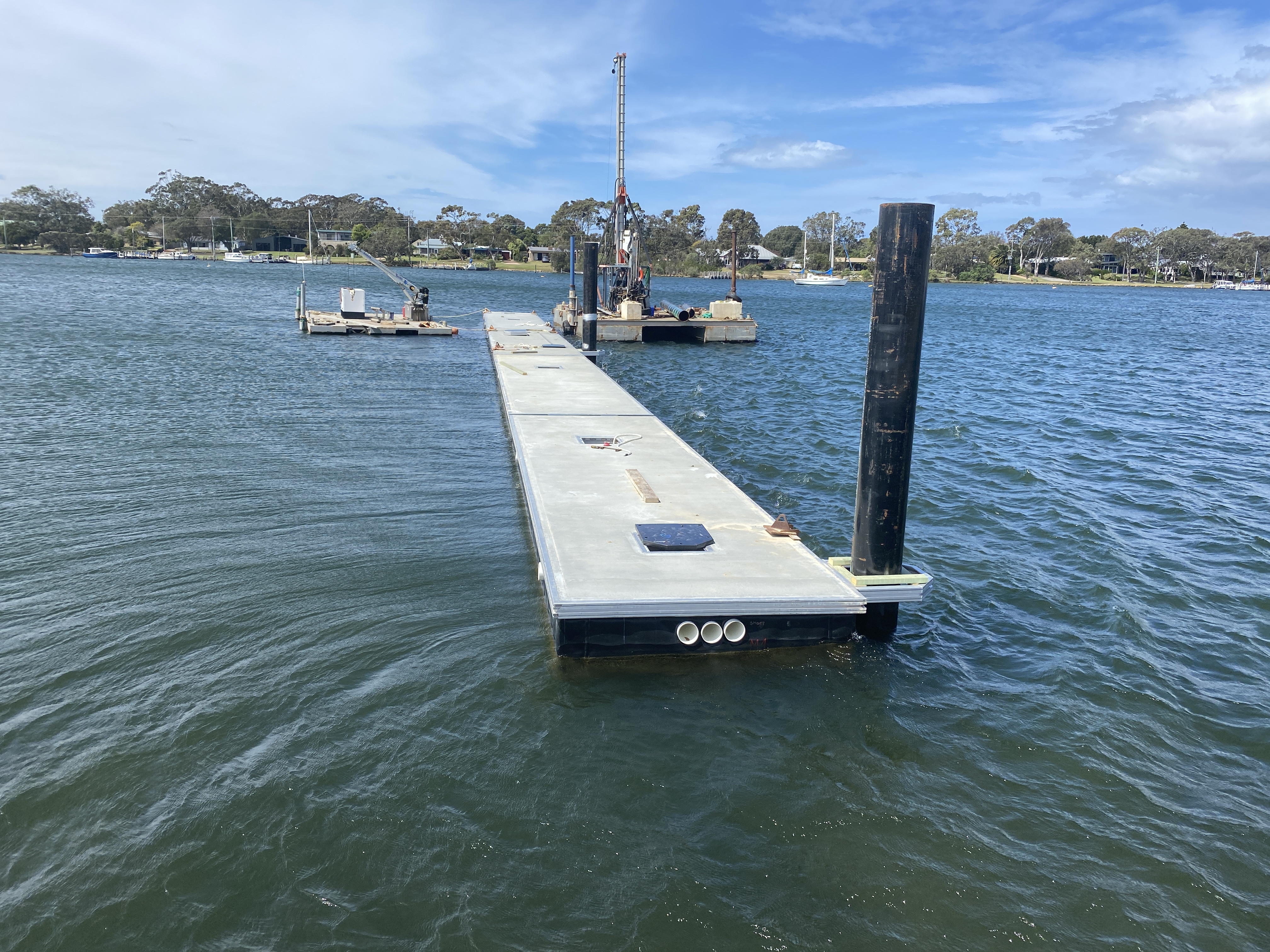

The first sections of Jetty 3 have now been successfully installed – marking another milestone in the transformation of the Paynesville Maritime Precinct
This new jetty will span approximately 80 metres in length and 2.4 metres in width, creating a total of around 40 new berths in the marina. Once complete, it will feature floating finger pontoon jetties on either side and a gangway to provide safe and convenient access from land.
These upgrades are designed to enhance access, usability, and enjoyment for both locals and visitors, supporting recreational boating, tourism, and local business opportunities.
What’s Happening Now:
- Floating Pontoons: Fabrication and installation continue, with the first section now in place.
- Landscaping: Kerbing, topsoil, and seeding are underway behind the northern seawall to green and beautify the area.
- Boat Ramp Upgrade: A new, longer and deeper commercial boat ramp is being prefabricated and installed to improve functionality.
- Utilities Commissioning: Power, water, and fire services are being activated across the precinct.
- Car Park Improvements: Sealing, asphalting, and line marking are progressing to improve traffic flow and accessibility.
These works reflect our commitment to delivering a modern, functional, and inclusive maritime precinct that meets the needs of the Paynesville community and its visitors.
Thank you for your continued interest and support – we look forward to sharing more updates as the project progresses.



-
📅 September 2025
Share 📅 September 2025 on Facebook Share 📅 September 2025 on Twitter Share 📅 September 2025 on Linkedin Email 📅 September 2025 linkWhat's happening now- The northern seawall installation is complete, with geotechnical backfill underway.
- Fabrication of floating pontoons is in progress.
- The southern section of the project has been topsoiled and hydro-seeded to ensure maximum growth over spring.
We've had discussions with stakeholders regarding the extension of jetty lengths, which have produced favourable outcomes. One fixed jetty north of the boat ramp will be replaced with two floating jetties, located north and south of the ramp. This also improves the usability of the commercial boat ramp, based on stakeholder input.Upcoming works- Continued fabrication and installation of floating pontoons
- Installation of kerb, topsoil, and seeding behind the northern seawall
- Pre-fabrication and installation of a new, longer and deeper commercial boat ramp
- Completion of the service jetty installation
- Commissioning of all service connections (power, water, fire)
- Car park sealing and asphalting
- Car park line marking









Road alignment amended allow for rainwater runoff. Proposed basin for lake inundation during high tides.
Kerb and underground drainage complete. Area being topsoiled and hydroseeded over the next week.4th section of 40 pontoon sections complete.
Preparation for timber edged cement treated gravel path nearing completion.
What's happening now- The northern seawall installation is complete, with geotechnical backfill underway.
- Fabrication of floating pontoons is in progress.
- The southern section of the project has been topsoiled and hydro-seeded to ensure maximum growth over spring.
We've had discussions with stakeholders regarding the extension of jetty lengths, which have produced favourable outcomes. One fixed jetty north of the boat ramp will be replaced with two floating jetties, located north and south of the ramp. This also improves the usability of the commercial boat ramp, based on stakeholder input.Upcoming works- Continued fabrication and installation of floating pontoons
- Installation of kerb, topsoil, and seeding behind the northern seawall
- Pre-fabrication and installation of a new, longer and deeper commercial boat ramp
- Completion of the service jetty installation
- Commissioning of all service connections (power, water, fire)
- Car park sealing and asphalting
- Car park line marking









Road alignment amended allow for rainwater runoff. Proposed basin for lake inundation during high tides.
Kerb and underground drainage complete. Area being topsoiled and hydroseeded over the next week.4th section of 40 pontoon sections complete.
Preparation for timber edged cement treated gravel path nearing completion.
-
📅 August 2025
Share 📅 August 2025 on Facebook Share 📅 August 2025 on Twitter Share 📅 August 2025 on Linkedin Email 📅 August 2025 link- The northern seawall is nearing completion.

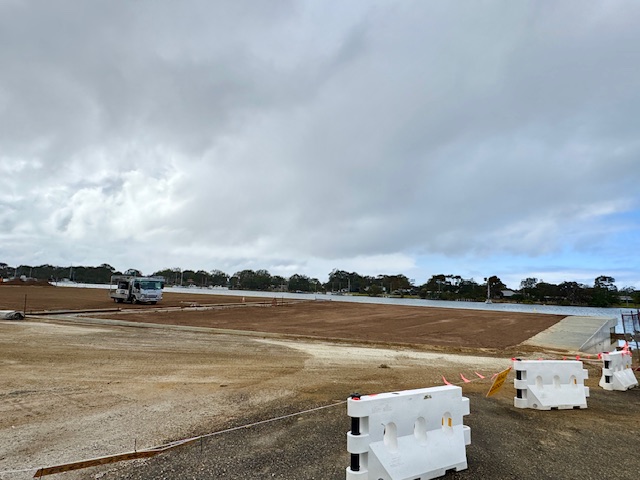

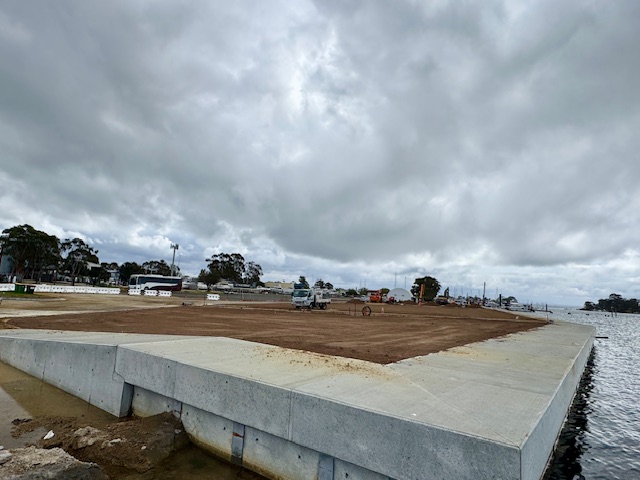

- Construction of the new carpark is underway, helping to improve access and convenience for all visitors.
The new seawall and carpark have been designed in a way that allows flood water to overflow into the carpark during flood related lake level rises and then dissipate more quickly through an improved carpark drainage system. This design approach aims to ensure that upgrade works don’t transfer flooding from the public carpark into surrounding areas such as roads & private property.
The new seawall doesn't impact McMillan Strait flows as it is located outside the main channel and tidal flows. The revised documents are available in the documents section on this page:
Behind the scenes, the redesigned boat ramp is being prefabricated, and work on the floating pontoon jetties are progressing well. These upgrades will make launching and docking safer and easier for everyone.
On the ground, crews are busy installing service conduits, kerbing, and drainage, laying the foundation for a more functional and welcoming space.

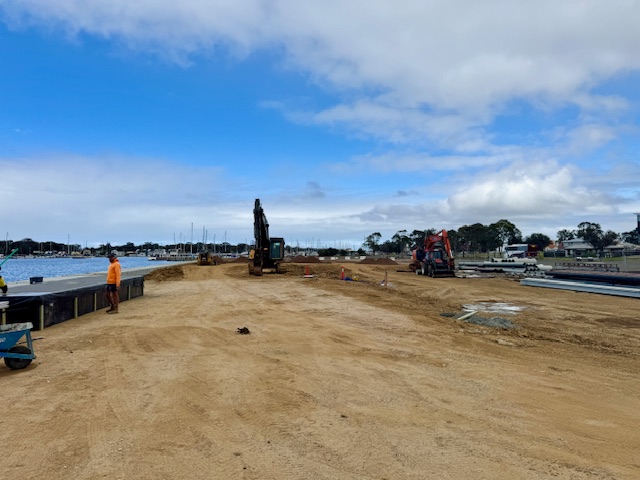

- The northern seawall is nearing completion.
- Construction of the new carpark is underway, helping to improve access and convenience for all visitors.
The new seawall and carpark have been designed in a way that allows flood water to overflow into the carpark during flood related lake level rises and then dissipate more quickly through an improved carpark drainage system. This design approach aims to ensure that upgrade works don’t transfer flooding from the public carpark into surrounding areas such as roads & private property.
The new seawall doesn't impact McMillan Strait flows as it is located outside the main channel and tidal flows. The revised documents are available in the documents section on this page:
Behind the scenes, the redesigned boat ramp is being prefabricated, and work on the floating pontoon jetties are progressing well. These upgrades will make launching and docking safer and easier for everyone.
On the ground, crews are busy installing service conduits, kerbing, and drainage, laying the foundation for a more functional and welcoming space.
-
📅 July 2025
Share 📅 July 2025 on Facebook Share 📅 July 2025 on Twitter Share 📅 July 2025 on Linkedin Email 📅 July 2025 linkMEDIA RELEASE
Paynesville’s Slip Road Maritime Precinct is taking shape, with East Gippsland Shire Council confirming the next phase of construction to improve car parking and drainage at the site.
The Slip Road Maritime Precinct project was initiated in response to strong demand for additional berthing in Paynesville and across the Gippsland Lakes – one of Australia’s premier boating destinations. While the precinct supports recreational users, it also plays a critical role in servicing the local marine industry, a key economic driver for East Gippsland.
Visitors to the precinct can already see progress underway, including a concrete panel seawall that now protects the foreshore and sets the footprint for the new facilities.
At its meeting on Tuesday night, Council approved a variation to the existing construction contract with Carter Marine Group. This variation enables the delivery of critical works, including the redesigned car park, kerb and channel, underground drainage, infrastructure, pathways and service connections.
These upgrades follow extensive engineering advice and geotechnical investigations, ensuring the new infrastructure is built to withstand coastal conditions and reduce the impact of flooding.
MEDIA RELEASE
Paynesville’s Slip Road Maritime Precinct is taking shape, with East Gippsland Shire Council confirming the next phase of construction to improve car parking and drainage at the site.
The Slip Road Maritime Precinct project was initiated in response to strong demand for additional berthing in Paynesville and across the Gippsland Lakes – one of Australia’s premier boating destinations. While the precinct supports recreational users, it also plays a critical role in servicing the local marine industry, a key economic driver for East Gippsland.
Visitors to the precinct can already see progress underway, including a concrete panel seawall that now protects the foreshore and sets the footprint for the new facilities.
At its meeting on Tuesday night, Council approved a variation to the existing construction contract with Carter Marine Group. This variation enables the delivery of critical works, including the redesigned car park, kerb and channel, underground drainage, infrastructure, pathways and service connections.
These upgrades follow extensive engineering advice and geotechnical investigations, ensuring the new infrastructure is built to withstand coastal conditions and reduce the impact of flooding.
-
📅 May 2025
Share 📅 May 2025 on Facebook Share 📅 May 2025 on Twitter Share 📅 May 2025 on Linkedin Email 📅 May 2025 linkThings are moving along well, and we’re hitting some great milestones.
- Northern seawall panels: Pre-fabrication is approx. 75% complete, a major step forward in strengthening our coastal resilience.

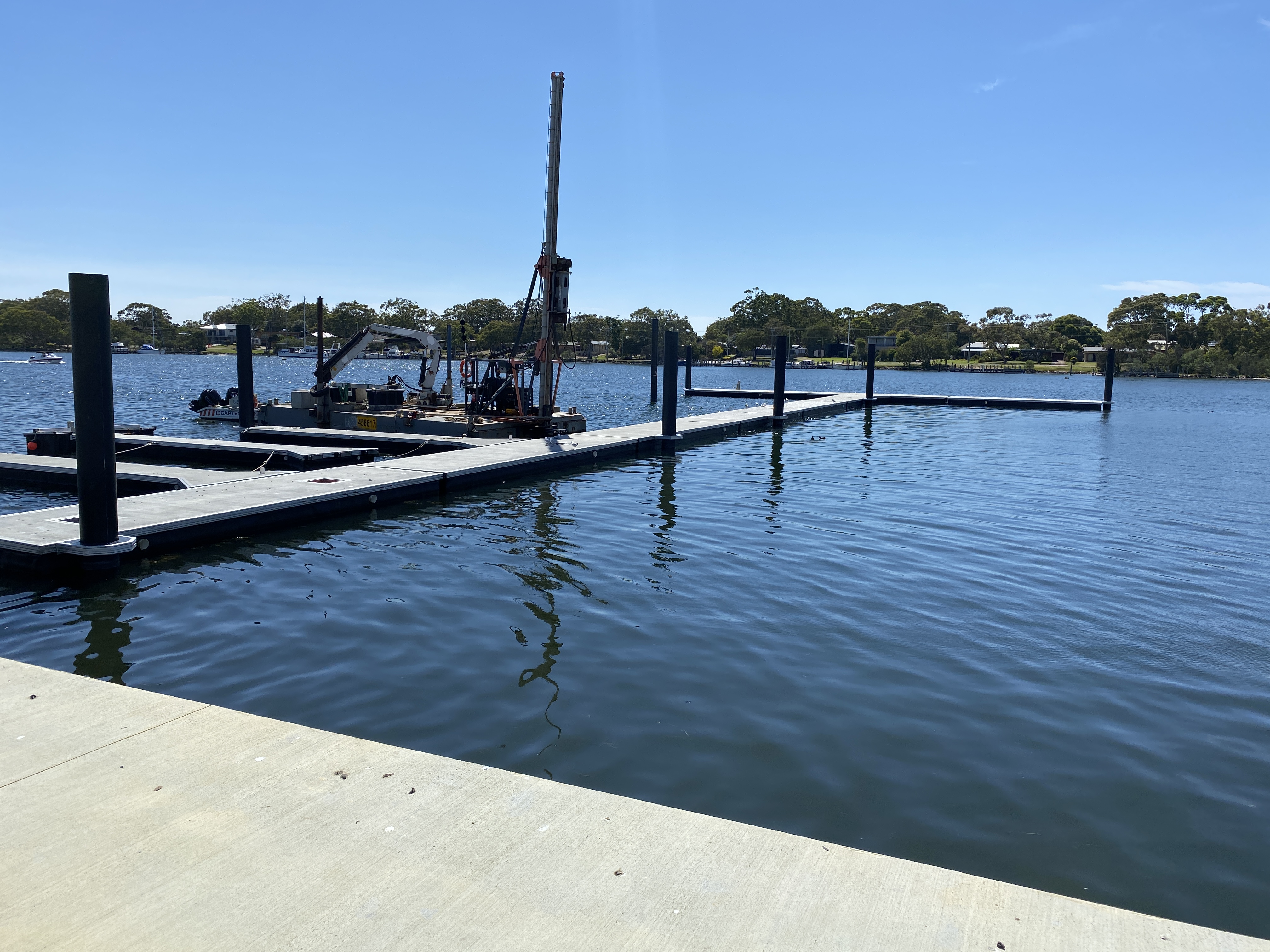

- Service jetty: Pile driving is around 70% complete, with beams and deck prefabrication underway.

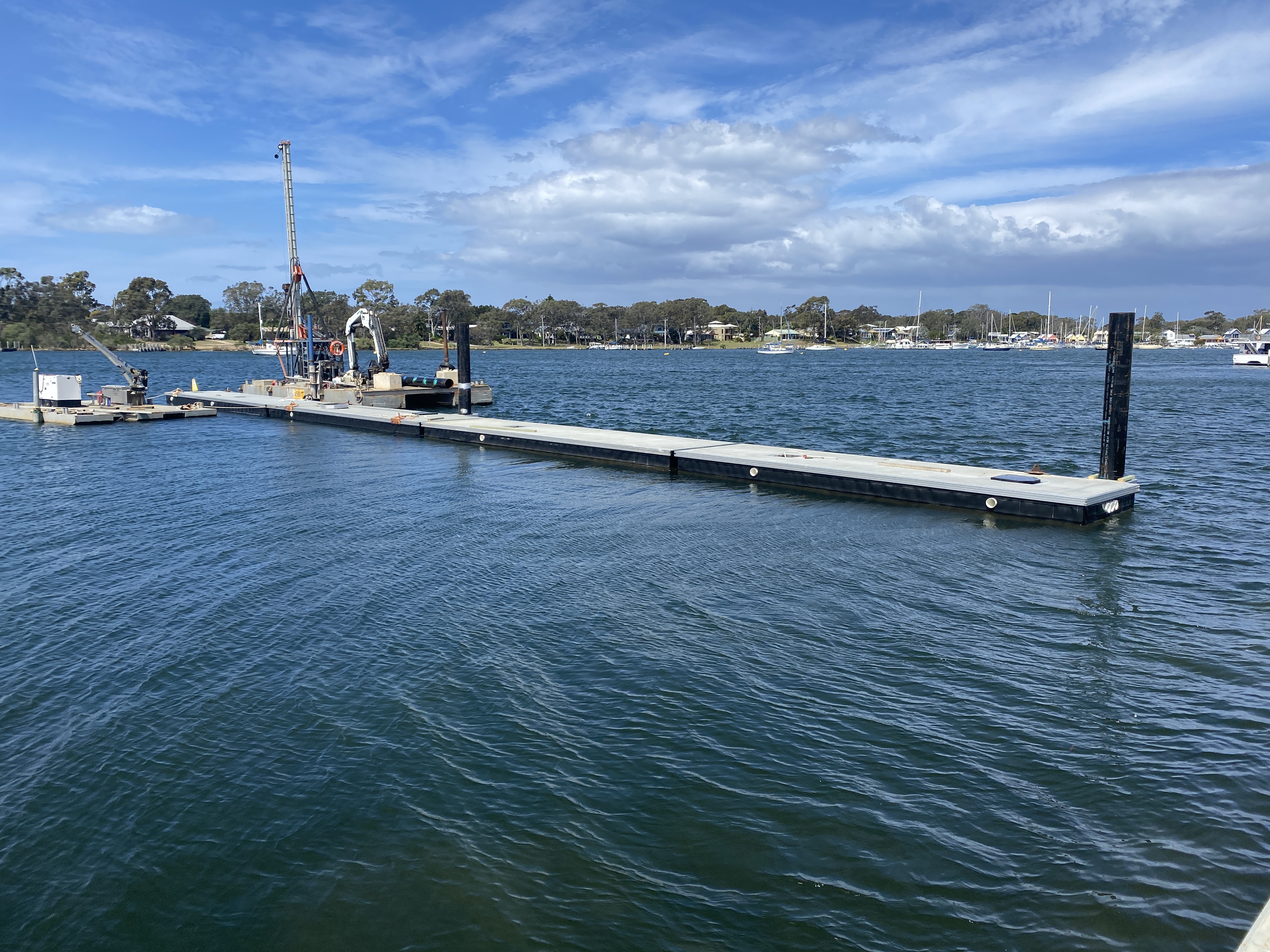

- Floating pontoon jetties: Design and general layout were endorsed by the CFA, and pre-fabrication commenced.
- We've completed 120m of Boardwalk and only have around 30m to go!
We appreciate the community’s continued support and patience as we work to deliver a safer, more accessible, and future-ready waterfront.Things are moving along well, and we’re hitting some great milestones.
- Northern seawall panels: Pre-fabrication is approx. 75% complete, a major step forward in strengthening our coastal resilience.
- Service jetty: Pile driving is around 70% complete, with beams and deck prefabrication underway.
- Floating pontoon jetties: Design and general layout were endorsed by the CFA, and pre-fabrication commenced.
- We've completed 120m of Boardwalk and only have around 30m to go!
We appreciate the community’s continued support and patience as we work to deliver a safer, more accessible, and future-ready waterfront. -
9 December 2024
Share 9 December 2024 on Facebook Share 9 December 2024 on Twitter Share 9 December 2024 on Linkedin Email 9 December 2024 linkThe front section of southern seawall is now complete.
The front section of southern seawall is now complete.
-
14 November 2024
Share 14 November 2024 on Facebook Share 14 November 2024 on Twitter Share 14 November 2024 on Linkedin Email 14 November 2024 linkWe are pleased to report significant progress on the maritime precinct upgrade:
- Southern Slip Road Seawall: Installation of concrete panels has now commenced for the southern section of the seawall.
- Northern Slip Road Seawall: Pile driving activities will continue over the coming months for the northern section. Following completion of this work, concrete panels will be installed.
- Floating Pontoons: The design phase for the floating pontoons is nearing completion, and we anticipate offsite prefabrication starting in February 2025.
- Boat Ramp & Service Jetty: Construction is scheduled to begin in March 2025.
We will continue to monitor progress and provide updates as Carter Marine progresses work on these key components.
We welcome your continued interest in this project. Please feel free to share this update with your local network and choose to follow this project on YourSay to receive important information regarding this project directly to your inbox.
We are pleased to report significant progress on the maritime precinct upgrade:
- Southern Slip Road Seawall: Installation of concrete panels has now commenced for the southern section of the seawall.
- Northern Slip Road Seawall: Pile driving activities will continue over the coming months for the northern section. Following completion of this work, concrete panels will be installed.
- Floating Pontoons: The design phase for the floating pontoons is nearing completion, and we anticipate offsite prefabrication starting in February 2025.
- Boat Ramp & Service Jetty: Construction is scheduled to begin in March 2025.
We will continue to monitor progress and provide updates as Carter Marine progresses work on these key components.
We welcome your continued interest in this project. Please feel free to share this update with your local network and choose to follow this project on YourSay to receive important information regarding this project directly to your inbox.
-
16 September 2024
Share 16 September 2024 on Facebook Share 16 September 2024 on Twitter Share 16 September 2024 on Linkedin Email 16 September 2024 linkFurther updates will be provided on YourSay following the Council Election on 26 October 2024, and the questions/feedback tab will be reinstated.
From 12.00 noon Tuesday 17 September until 6.00 pm on Saturday 26 October (Election Day) we will be in the Local Government Election Period (also known as Caretaker Period).
During this time, we will limit our printed communications, website content, social media activity, and community consultations. The ability for people to comment on our social media content will also be disabled during the Election Period.
Each of these steps is to ensure our content does not affect voting in the election and is consistent with steps taken by other Victorian Councils and the Local Government Act 2020.
These changes are only temporary; we'll be back to normal communication activity after the election.
Further updates will be provided on YourSay following the Council Election on 26 October 2024, and the questions/feedback tab will be reinstated.
From 12.00 noon Tuesday 17 September until 6.00 pm on Saturday 26 October (Election Day) we will be in the Local Government Election Period (also known as Caretaker Period).
During this time, we will limit our printed communications, website content, social media activity, and community consultations. The ability for people to comment on our social media content will also be disabled during the Election Period.
Each of these steps is to ensure our content does not affect voting in the election and is consistent with steps taken by other Victorian Councils and the Local Government Act 2020.
These changes are only temporary; we'll be back to normal communication activity after the election.
-
12 September 2024
Share 12 September 2024 on Facebook Share 12 September 2024 on Twitter Share 12 September 2024 on Linkedin Email 12 September 2024 link- Using the barge, piles are installed ready for splicing/welding.

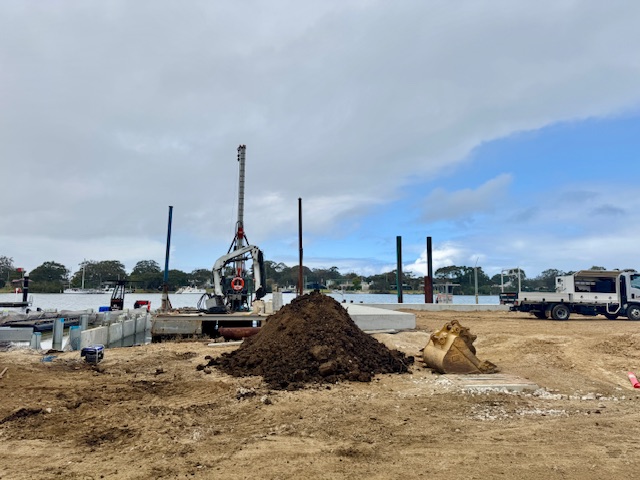

- A third-party contractor is conducting tests on the driven piles to ensure they have reached the necessary refusal strength. This process allows us to quickly evaluate key factors such as the pile’s load-bearing capacity, the stress on the steel, the overall integrity of the pile, and the effectiveness of the pile driving process.
- Once the piles have successfully passed these tests, we will move forward with installing the seawall panels.
- Carter Marine are anticipated to complete the seawall, jetties, and all associated works by December 2025.

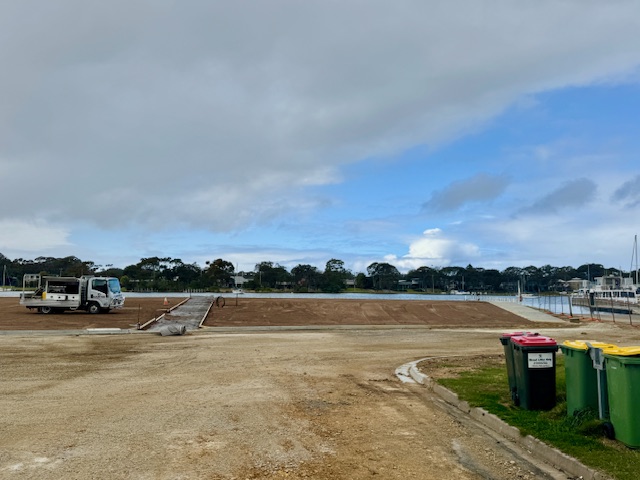

The carpark design is in the concept stage and will progress to the preliminary stage over the coming month. The preliminary design will be made available on YourSay following the Council Election period.
- Using the barge, piles are installed ready for splicing/welding.
- A third-party contractor is conducting tests on the driven piles to ensure they have reached the necessary refusal strength. This process allows us to quickly evaluate key factors such as the pile’s load-bearing capacity, the stress on the steel, the overall integrity of the pile, and the effectiveness of the pile driving process.
- Once the piles have successfully passed these tests, we will move forward with installing the seawall panels.
- Carter Marine are anticipated to complete the seawall, jetties, and all associated works by December 2025.
The carpark design is in the concept stage and will progress to the preliminary stage over the coming month. The preliminary design will be made available on YourSay following the Council Election period.
Signup Banner
Follow Project
Who's Listening
-
Phone 03 5153 9500 Email feedback@egipps.vic.gov.au
FB 19-09-25
Photos
Media Releases
- Slip Road Maritime Precinct upgrade enters final stages | Date of Issue: February 23, 2026
- Slip Road project continues with car park and drainage upgrade confirmed| Date of Issue: July 18, 2025
- Responsible Council budget delivers for community | Date of Issue: 27 June 2024
- Work on Paynesville's Slip Road Maritime Precinct to recommence | Date of Issue: February 21, 2024
- Slip Road, Paynesville project delayed | Date of Issue: January 25, 2023
Documents
-
Jetty Layout November 2025.pdf (122 KB) (pdf)
-
North Boat Ramp drawings - August 2025 (1.92 MB) (pdf)
-
Proposed design (7.22 MB) (pdf)
-
July 2025
-
Seawall Designs
-
superseded files
-
Final layout plan - 7/07/2021 (6.25 MB) (pdf)
-
Concept Design - Version 2 - April 2021 (288 KB) (png)
-
Drawing layout (290 KB) (pdf)
-
Summary report Slip Road Community Consultation (637 KB) (pdf)
-
Slip Road Canal Crossing CBA-FINAL - 15-06-21 (865 KB) (pdf)
-
Concept Design - Version 1 - December 2020 (2.66 MB) (jpg)
-
Slip Road Maritime Precinct Concept Plan Addendum - 17/06/2021 (519 KB) (pdf)
-
