Lakes Entrance - Transfer Station refurbishment
All civil works at the Lakes Entrance transfer station have been completed, including drainage works, asphalting, and line marking.
Project Description
Upgrade of the existing Transfer Station to comply with industry best practice requirements.
Objectives and Scope
Install new saw tooth bays, hardstands and sealed roadways.

If you would like to search for other past, current or future projects in your town, simply type your town name in the search bar.
Project Description
Upgrade of the existing Transfer Station to comply with industry best practice requirements.
Objectives and Scope
Install new saw tooth bays, hardstands and sealed roadways.

If you would like to search for other past, current or future projects in your town, simply type your town name in the search bar.
All civil works at the Lakes Entrance transfer station have been completed, including drainage works, asphalting, and line marking.
-
Project Update - 17 January 2024
Share Project Update - 17 January 2024 on Facebook Share Project Update - 17 January 2024 on Twitter Share Project Update - 17 January 2024 on Linkedin Email Project Update - 17 January 2024 linkProject is nearing completion.
All civil works at the Lakes Entrance transfer station have been completed, including drainage works, asphalting, and line marking.
New signage is anticipated to be installed in the coming weeks.
Project is nearing completion.
All civil works at the Lakes Entrance transfer station have been completed, including drainage works, asphalting, and line marking.
New signage is anticipated to be installed in the coming weeks.
All civil works at the Lakes Entrance transfer station have been completed, including drainage works, asphalting, and line marking.
-
Project Update 11/05/2023
Share Project Update 11/05/2023 on Facebook Share Project Update 11/05/2023 on Twitter Share Project Update 11/05/2023 on Linkedin Email Project Update 11/05/2023 linkThe three old bin bays were worked on during April to construct new edge beams and approach slabs. This work was completed.
The new gates and rails are currently being galvanised, and are expected to be installed during the week commencing 15 May 2023.
Next week (commencing 8 May), the drainage pit modifications in the bin forecourt area will be performed, allowing pavements to commence the following week (15 May).
Following finalisation of the crushed rock pavements, the sealing and asphalting can be performed.
The three old bin bays were worked on during April to construct new edge beams and approach slabs. This work was completed.
The new gates and rails are currently being galvanised, and are expected to be installed during the week commencing 15 May 2023.
Next week (commencing 8 May), the drainage pit modifications in the bin forecourt area will be performed, allowing pavements to commence the following week (15 May).
Following finalisation of the crushed rock pavements, the sealing and asphalting can be performed.
All civil works at the Lakes Entrance transfer station have been completed, including drainage works, asphalting, and line marking.
-
Project Update 1/03/2022
Share Project Update 1/03/2022 on Facebook Share Project Update 1/03/2022 on Twitter Share Project Update 1/03/2022 on Linkedin Email Project Update 1/03/2022 linkThe Saw Tooth bays have been completed and works on the road sealing will commence in March
The Saw Tooth bays have been completed and works on the road sealing will commence in March
All civil works at the Lakes Entrance transfer station have been completed, including drainage works, asphalting, and line marking.
-
Project Update 9/02/2022
Share Project Update 9/02/2022 on Facebook Share Project Update 9/02/2022 on Twitter Share Project Update 9/02/2022 on Linkedin Email Project Update 9/02/2022 linkSaw Tooth bay walls have been placed and back filling has begun.
Saw Tooth bay walls have been placed and back filling has begun.
All civil works at the Lakes Entrance transfer station have been completed, including drainage works, asphalting, and line marking.
-
Project Update 11/08/2021

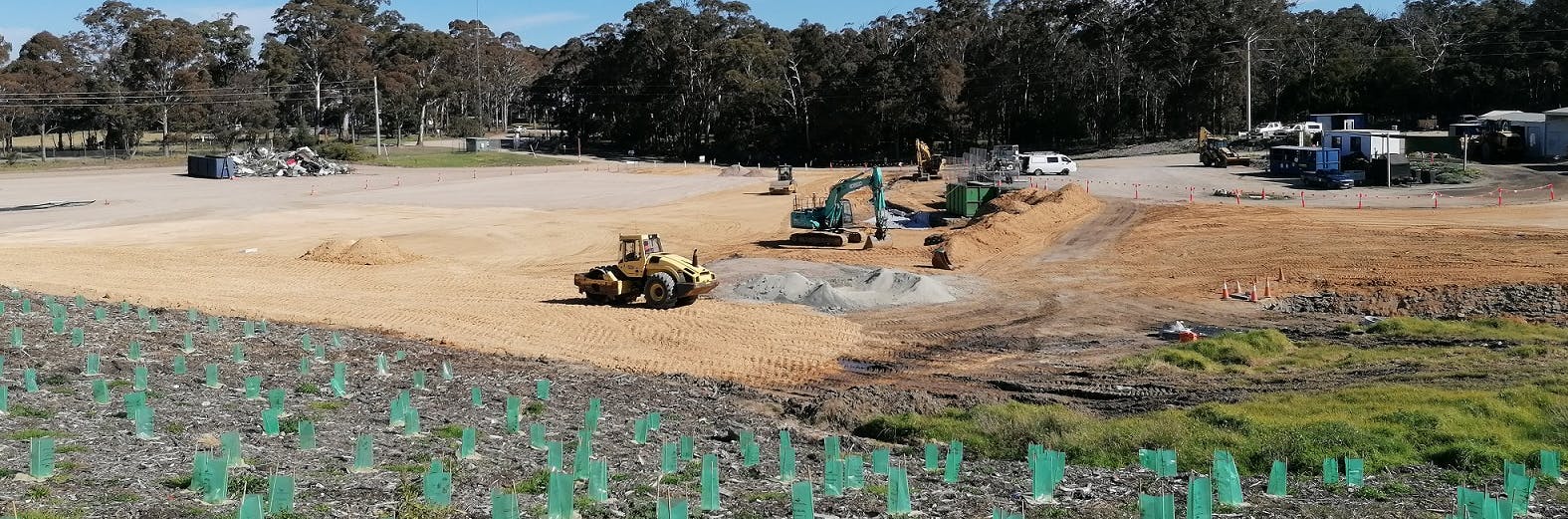

Share Project Update 11/08/2021 on Facebook Share Project Update 11/08/2021 on Twitter Share Project Update 11/08/2021 on Linkedin Email Project Update 11/08/2021 linkWork is also progressing, with the hardstand areas taking shape after the install of the drainage pipe work last week.
Work is also progressing, with the hardstand areas taking shape after the install of the drainage pipe work last week.
All civil works at the Lakes Entrance transfer station have been completed, including drainage works, asphalting, and line marking.
-
Project Update 28/07/2021
Share Project Update 28/07/2021 on Facebook Share Project Update 28/07/2021 on Twitter Share Project Update 28/07/2021 on Linkedin Email Project Update 28/07/2021 linkRefurb works have continued this week, with the relocation of the green waste and metal pile to the new hardstand area.
Refurb works have continued this week, with the relocation of the green waste and metal pile to the new hardstand area.
All civil works at the Lakes Entrance transfer station have been completed, including drainage works, asphalting, and line marking.
-
Project Update 22/07/2021
Share Project Update 22/07/2021 on Facebook Share Project Update 22/07/2021 on Twitter Share Project Update 22/07/2021 on Linkedin Email Project Update 22/07/2021 linkRefurbishment works have continued this week, with the Saw tooth bay location being readied for the instillation of the concrete retaining walls.
Refurbishment works have continued this week, with the Saw tooth bay location being readied for the instillation of the concrete retaining walls.
All civil works at the Lakes Entrance transfer station have been completed, including drainage works, asphalting, and line marking.
